Bridge
17 (uploaded 14 November 2008)
The term ‘Bridge’ is perhaps too grand for this
friendly little arch, but it is named thus in the original bridge
register. When built, around 1872, it was
a subway and carried the railway over a footpath. These days it carries the railway over a
small stream which emerges from Doncaster’s works, and which empties, a few
yards further downstream, into the headwaters of the Avon Llwyd, the principal
waterway in our valley, which flows down the valley to join the River Usk just
north of Newport. Locally we call it
‘Doncaster’s Stream Bridge’.
Despite its simple appearance a careful examination
has revealed that its western wall is tilting and there are planned to rebuild
it in the next few months

|
Water
gurgles happily from the arch, but unconstrained vegetation growth threatens
to engulf it. The delicate iron
railings have been dwarfed on this side by ‘safe’ wooden fencing. |

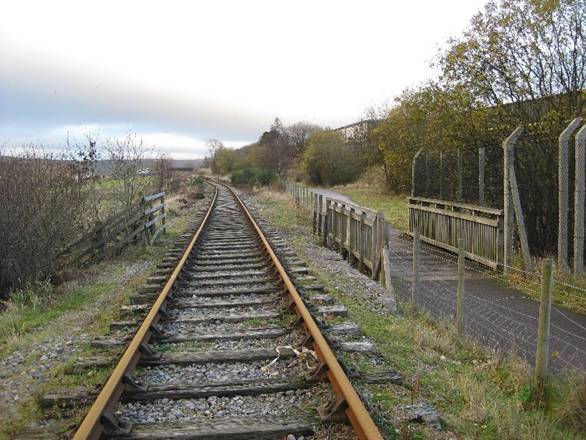

Viewed from
above, passengers will have little idea that they are travelling over the
arch. The wooden deck to the left is
carried on crude mass concrete abutments and carries the cycletrack – but was
it necessary to cut the existing railings back quite so far? |
WORK
BEGINS (added 9 January 2009)
There were times when we thought it might never
happen, but at long last, with design work is complete and contracts formally
let, work is beginning to start. Bridge
17 is the most southerly of the bridges to receive attention, and will be the
first to be repaired. Then,
successively, retreating northwards, Bridges 16, 14 and 13 (Bridge 15 was
filled-in in 1975) will receive attention, each, by coincidence, being more
difficult than its predecessor.
Contractors Griffiths of Abergavenny, are the main contractors, and we
expect them to be with us until mid-May.
|
|
|
|
|
Volunteer
Ian looks southwards from Bridge 17 on Sunday 4 January. On that day it was cleared of rail and sleepers in
severe cold weather by PBR volunteers, ready for work to begin. |
|
Viewed from
the embankment between Bridges 13 and 14 on 8 January, Griffiths can be seen
to have set up camp alongside the cycletrack.
Actual work on the bridge will begin on Monday 12th photo:Alastair Warrington |
WORK
PROGRESS (uploaded 17 January 2009)
The work on Bridge 16 (Doncaster’s) which looked
quite forbidding at first sight was done and dusted very quickly and without
problems. This is the most southerly bridge
for which work is scheduled, and since the line has to be cut further up the
line, it will be the last bridge on which track is finally laid before trains
can reach Blaenavon (High Level) again.
We anticipate that this will be in mid-May, but it could be a month
earlier.
|
Work in
progress on 13 January – the fence, of steel tube and cast iron posts has
been removed. Deep excavations show
where the west spandrel wall is being completely rebuilt img_1836rr |
By 17 January
the rebuilding work essentially complete, it only needs the sub-base to be
reinstalled. The original fence was
cruelly truncated to make room for the
wooden bridge, which was installed for the cycletrack a few years ago. img_1847rr |
By 22 January
the work is complete, except for relaying track and side ballasting. Since the line has been breached at each of
bridges 16, 14 and 13, it will be some months before this work is done –
indeed, it will be the last to be done. img_1862rr |
